April 2026 Community Update: Focused on More Progress

The below information has been provided in an effort to help keep the community informed on a more frequent basis about progress at the AltEn site.

Ever since AltEn ceased operations at its facility in Mead in 2021, the AltEn Facility Response Group (FRG) has been voluntarily working under the guidance of the Nebraska Department of Water, Energy, and Environment (NDWEE) to stabilize the AltEn site and develop a Remedial Action Plan (RAP) for the site. The FRG’s top priorities have been and continue to be to help ensure the safety of the surrounding community and environment. To-date, there has been no evidence of impacts to local drinking water.

The FRG is working diligently with the NDWEE to identify the most effective and safest methods to address the current environmental conditions on the AltEn site. The remedial action plans (RAP) will recommend remediation for components remaining on-site, including wastewater, sludge, and wet cake.

APRIL 23, 2026

Lagoon Solids RAP Approved

Following a comment period and recent public hearing the Nebraska Department of Water, Energy and Environment (NDWEE) approved the Lagoon Solids Remedial Action Plan (RAP) on April 10, 2026. Phase 1 implementation of the plan begins this summer.

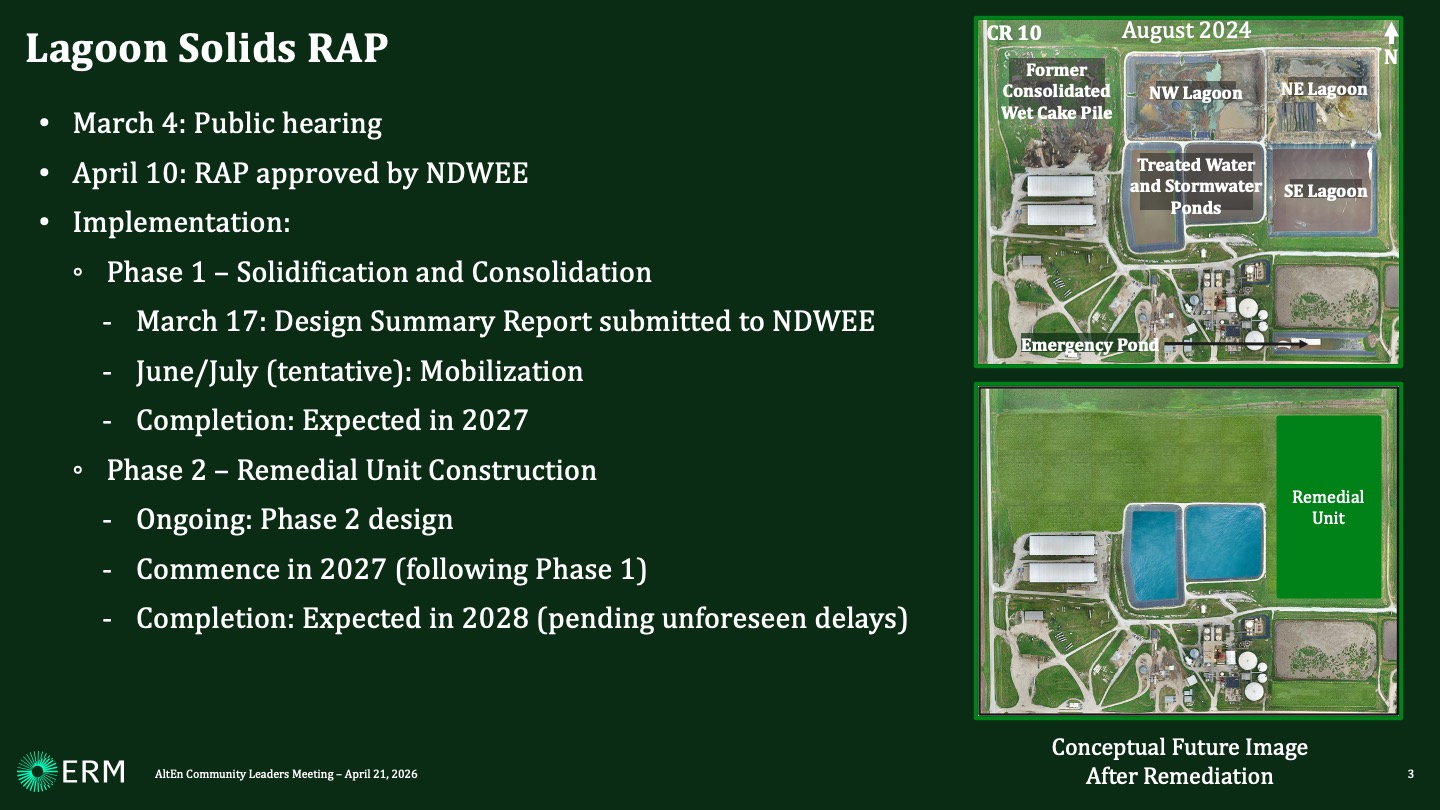

March 4: Public hearing April 10: RAP approved by NDWEE Implementation: Phase 1 – Solidification and Consolidation March 17: Design Summary Report submitted to NDWEE June/July (tentative): Mobilization Completion: Expected in 2027 Phase 2 – Remedial Unit Construction Ongoing: Phase 2 design Commence in 2027 (following Phase 1) Completion: Expected in 2028 (pending unforeseen delays)

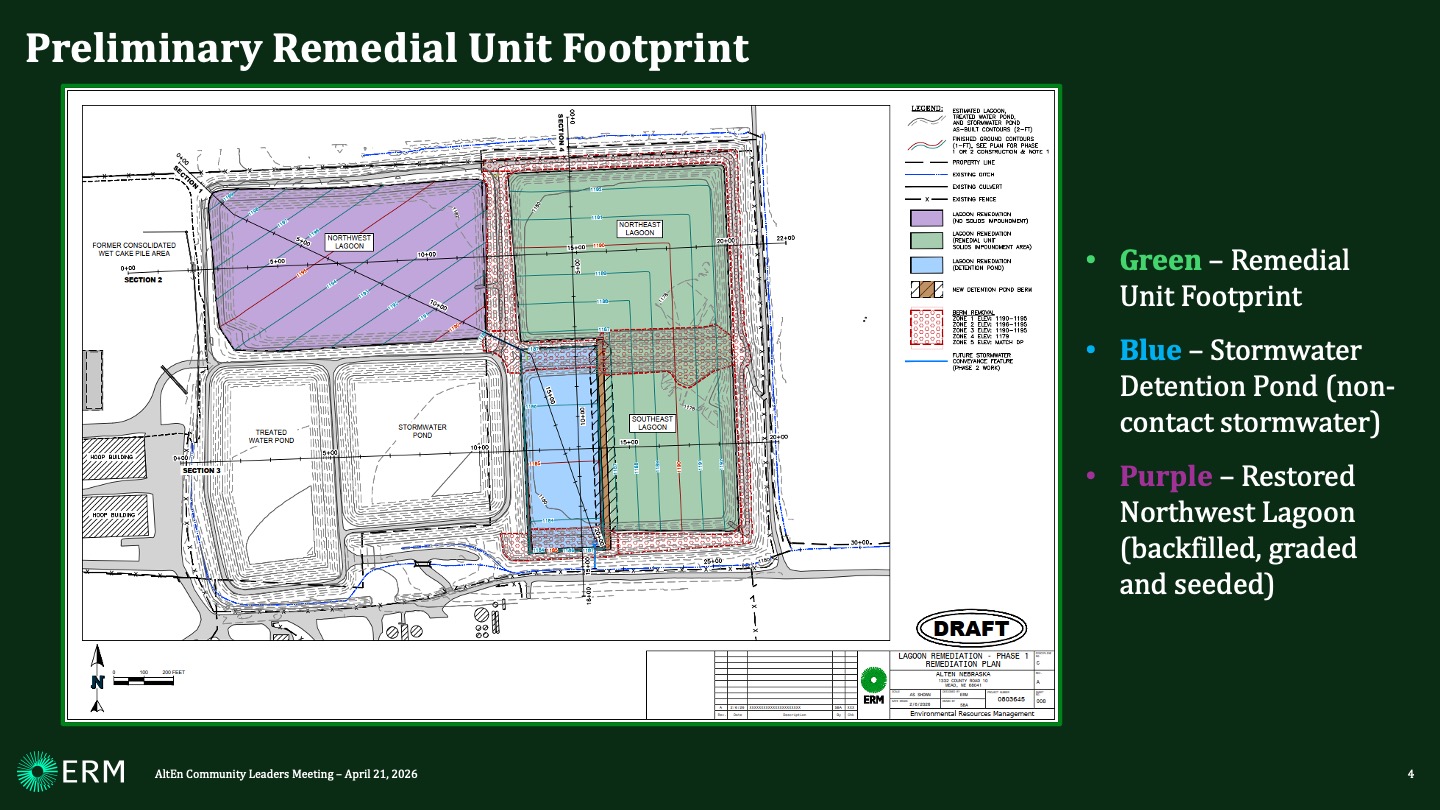

Preliminary Remedial Unit Footprint

Wet Cake Area Restoration: More Progress

After all wet cake was removed from the site in August 2025, fill material has been placed and graded over the former wet cake area. Restoration work has restarted and is expected to be completed in June 2026.
Wet cake removal was completed in August 2025 Fill material was placed and graded over the area to facilitate stormwater runoff More than 50% of the area was restored before winter break Restoration restarted April 13 Work is anticipated to be completed in June

Other Site Activities

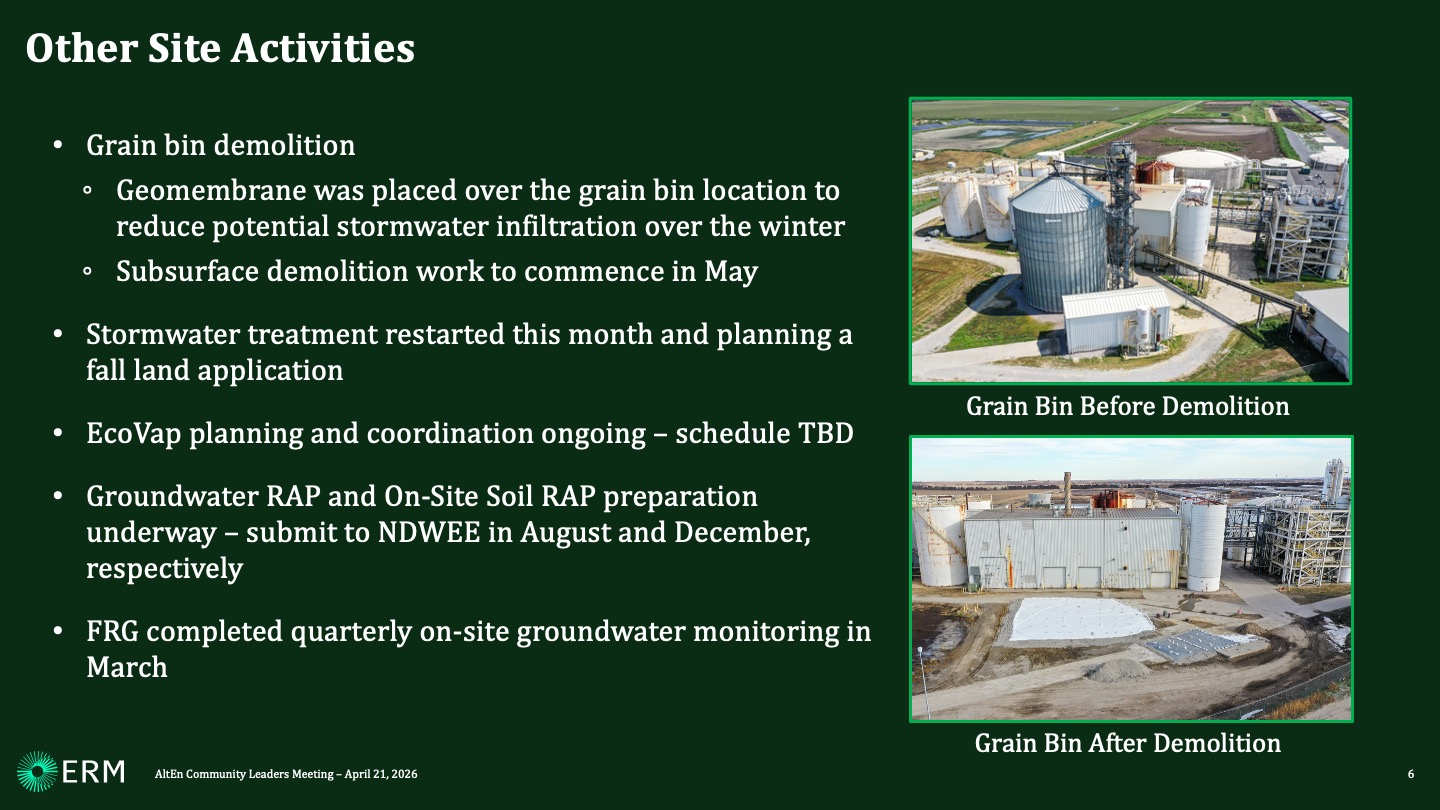

The AltEn site’s grain bin has been demolished, with subsurface demolition to begin next month. Stormwater treatment restarted in April 2026, with fall land application planned for later this year. On-site groundwater samples were taken in March 2026.

Stay Informed

Check alteninfo.com for the latest videos and other updates about AltEn site activities.
