June 2026 Community Update: Focused on More Progress

The below information has been provided in an effort to help keep the community informed on a more frequent basis about progress at the AltEn site.

Ever since AltEn ceased operations at its facility in Mead in 2021, the AltEn Facility Response Group (FRG) has been voluntarily working under the guidance of the Nebraska Department of Water, Energy, and Environment (NDWEE) to stabilize the AltEn site and develop a Remedial Action Plan (RAP) for the site. The FRG’s top priorities have been and continue to be to help ensure the safety of the surrounding community and environment. To-date, there has been no evidence of impacts to local drinking water.

The FRG is working diligently with the NDWEE to identify the most effective and safest methods to address the current environmental conditions on the AltEn site. The remedial action plans (RAP) will recommend remediation for components remaining on-site, including wastewater, sludge, and wet cake.

JUNE 25, 2026

Lagoon Solids RAP: Phase 1 is Underway

Phase 1 implementation of the Lagoon Solids RAP began in June with solidification and consolidation of materials. Phase 2 is set to begin in 2027.

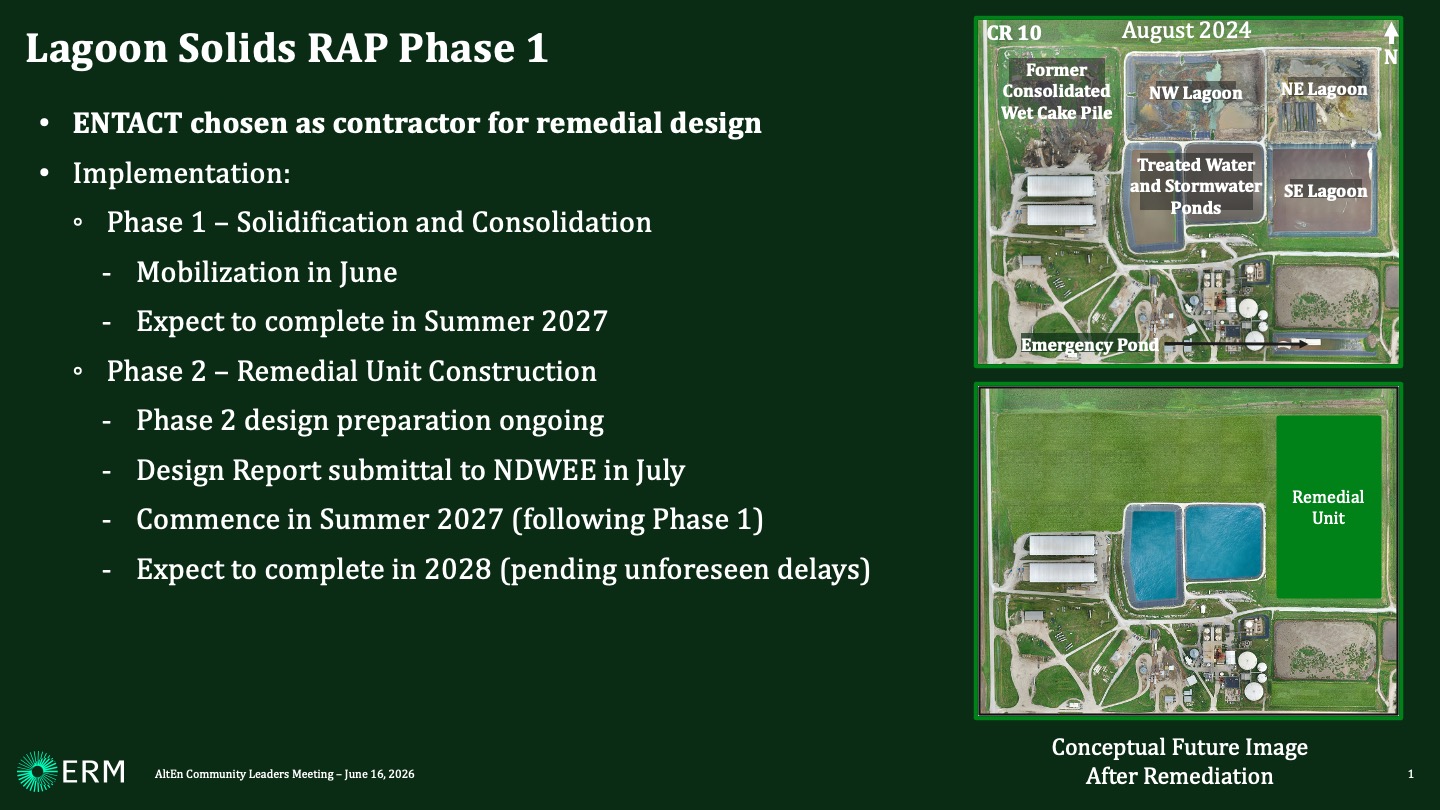

ENTACT chosen as contractor for remedial design Implementation: Phase 1 – Solidification and Consolidation Mobilization in June Expect to complete in Summer 2027 Phase 2 – Remedial Unit Construction Phase 2 design preparation ongoing Design Report submittal to NDWEE in July Commence in Summer 2027 (following Phase 1) Expect to complete in 2028 (pending unforeseen delays)

Wet Cake Area Restoration Continues

With the wet cake removal completed, fill material has been placed and graded with seeding added. Restoration work is set to be finished – a major milestone in site remediation.

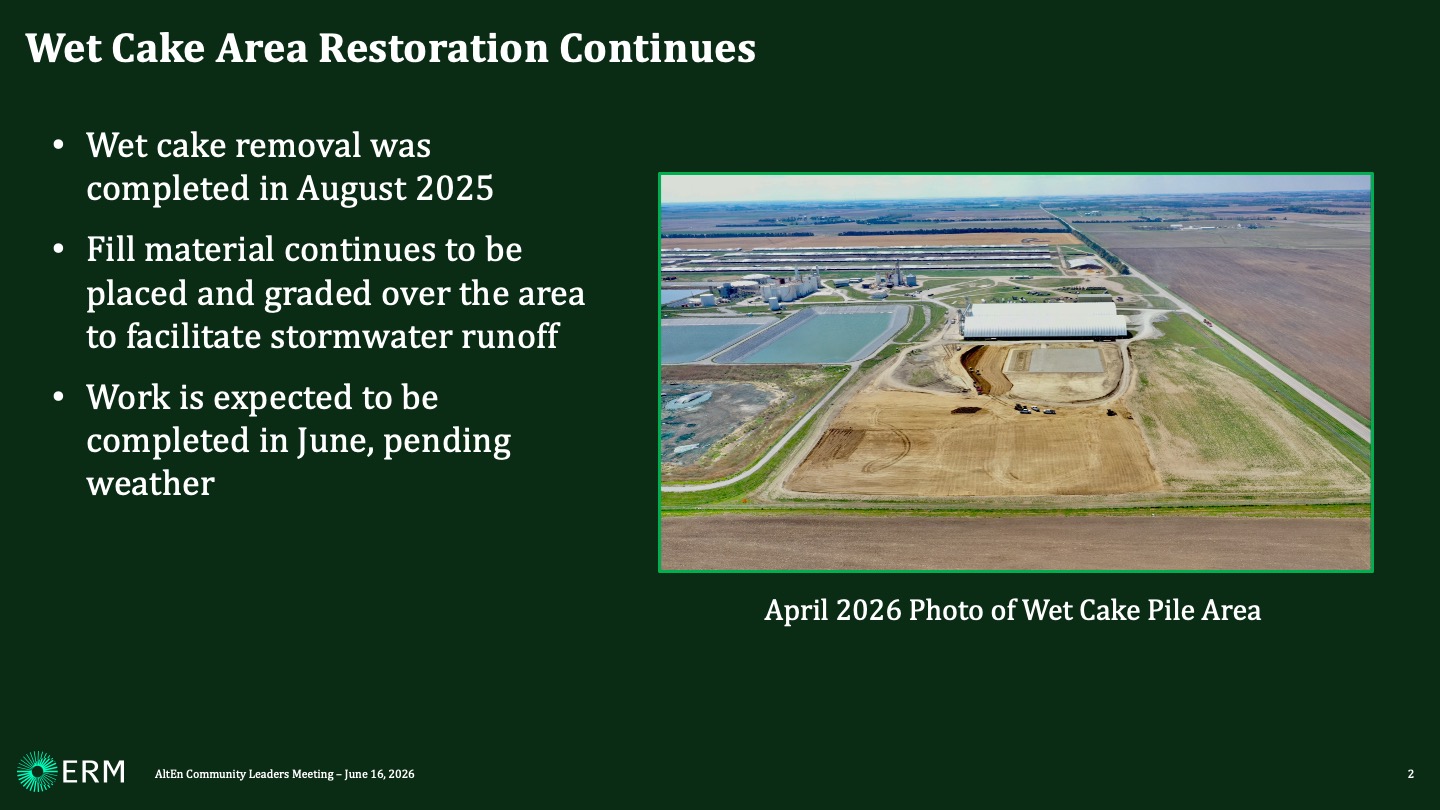

Wet cake removal was completed in August 2025 Fill material continues to be placed and graded over the area to facilitate stormwater runoff Work is expected to be completed in June, pending weather

Groundwater and Soil Sample Updates

Quarterly groundwater monitoring continues, with additional monitoring wells installed and subsurface soil samples collected.
New Plant Area Groundwater Monitoring Well Locations

Other Site Activities

Demolition of the former grain bin’s underground infrastructure is expected to begin in July. Stormwater treatment restarted in April 2026, with land application planned for this Fall. Planning continues for EcoVap, a water evaporation structure, as does preparation for Groundwater and On-Site Soil RAPs, with submission of both to the Nebraska Department of Water, Energy and Environment (NDWEE) later this year.

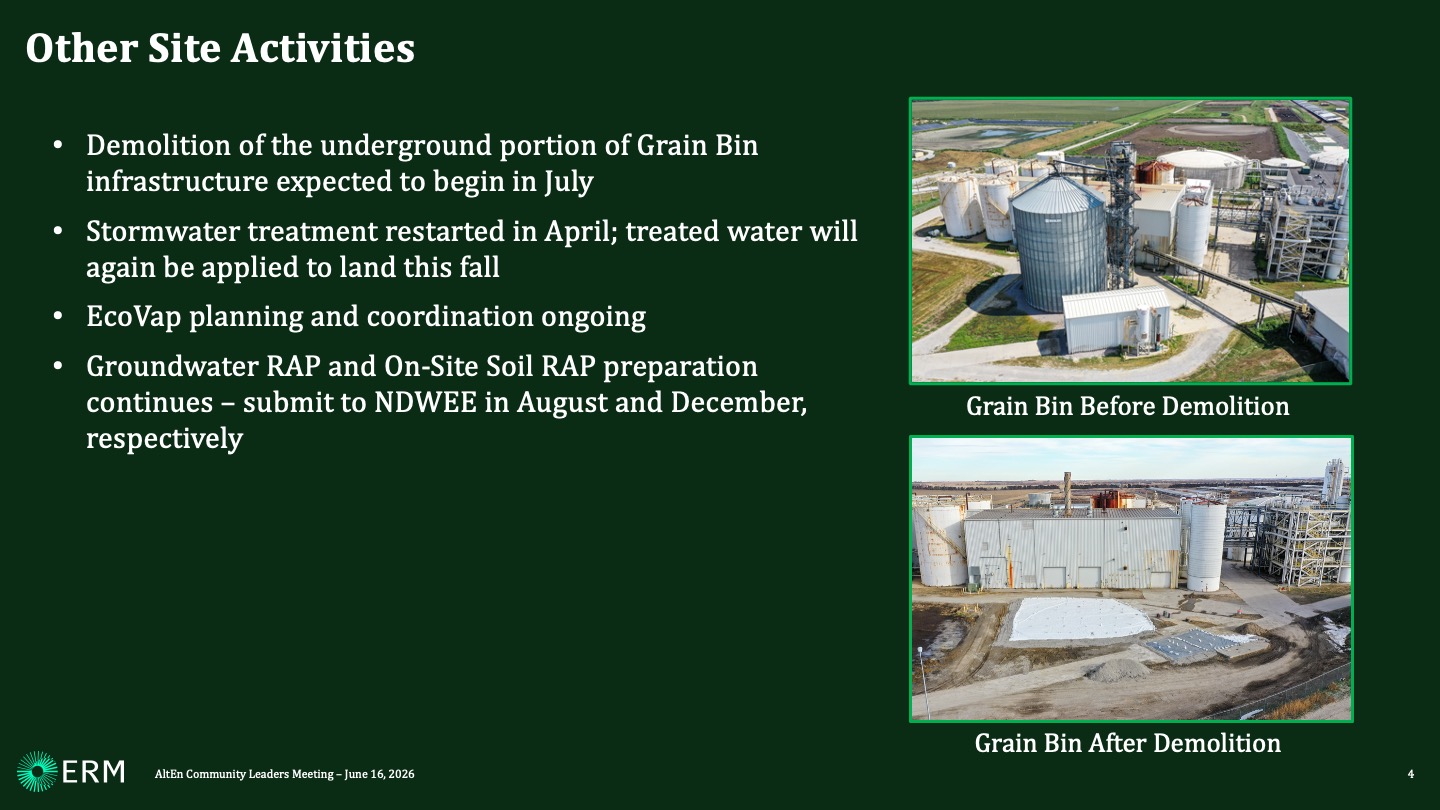

Demolition of the underground portion of Grain Bin infrastructure expected to begin in July Stormwater treatment restarted in April; treated water will again be applied to land this fall EcoVap planning and coordination ongoing Groundwater RAP and On-Site Soil RAP preparation continues – submit to NDWEE in August and December, respectively

Stay Informed

Check alteninfo.com for the latest videos and other updates about AltEn site activities.
